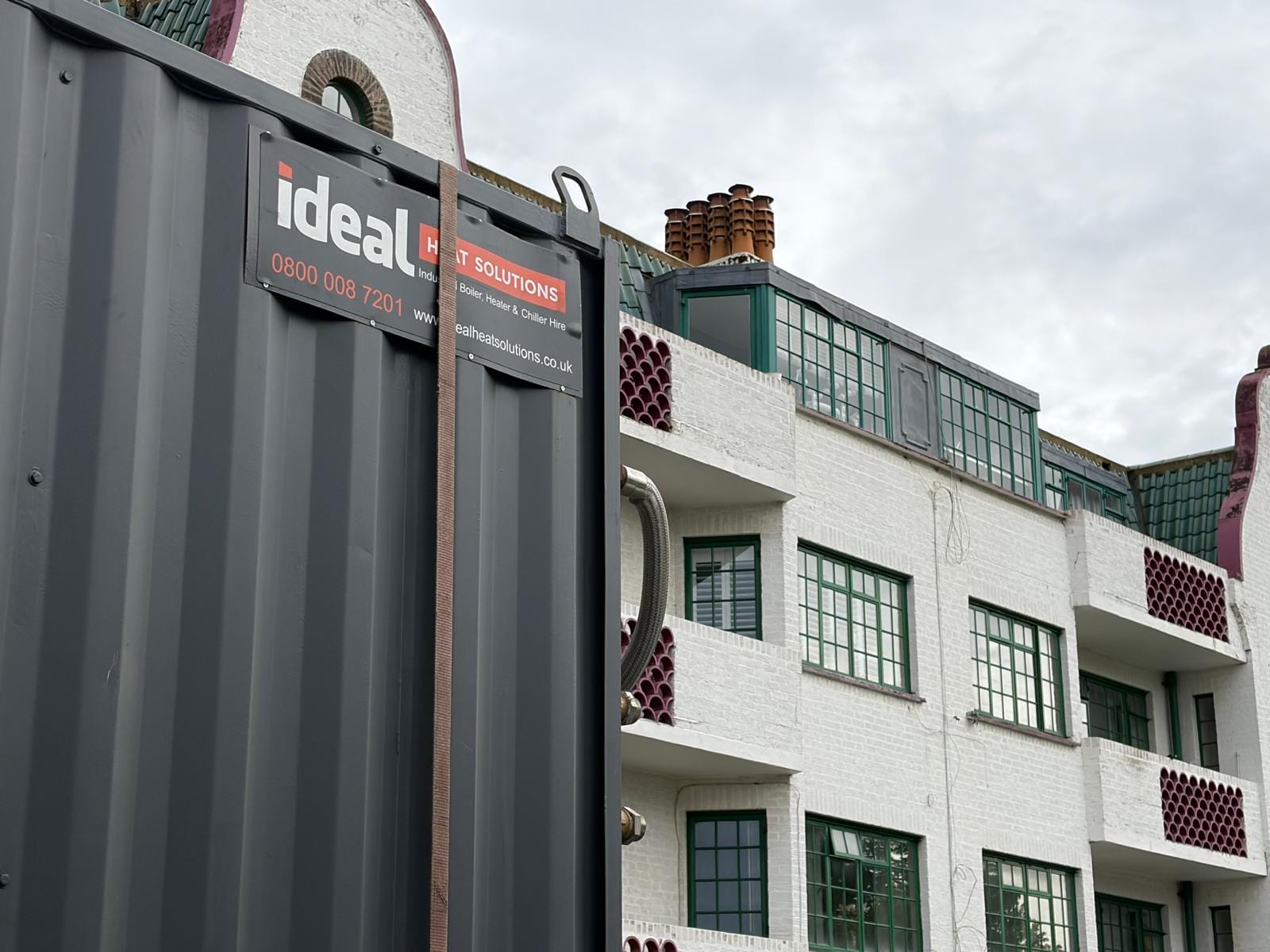

For property managers and building owners, boiler replacement is an inevitable part of maintaining a commercial asset. Whether it is a multi-tenanted office building, a retail development, a purpose-built student accommodation block, or a mixed-use residential scheme, the time will come when the plant room needs upgrading.
The challenge is that most commercial buildings cannot simply be vacated while the works take place. Tenants have leases, businesses have obligations, and residents have nowhere else to go. The solution is commercial boiler hire: a temporary heating and hot water system that keeps every occupant fully served throughout the replacement project.

Why Tenants Cannot Simply Be Without Heating
Commercial leases typically place an obligation on the landlord to provide heating and hot water as part of the service charge. Withdrawing these services, even temporarily, can expose the landlord to:
- Breach of lease claims from commercial tenants
- Service charge disputes and withholding
- Complaints from residential occupants with recourse under housing legislation
- Reputational damage affecting re-letting prospects
Beyond the legal and commercial risks, there is a straightforward duty of care. In the winter months, leaving occupied buildings without heating is simply not acceptable. Commercial boiler hire removes this risk entirely.
Planning the Temporary Boiler Hire Package
The most effective temporary boiler hire arrangements for planned refurbishments are set up well in advance of the works commencing. This allows:
- A thorough site survey to identify the optimal equipment location and connection strategy

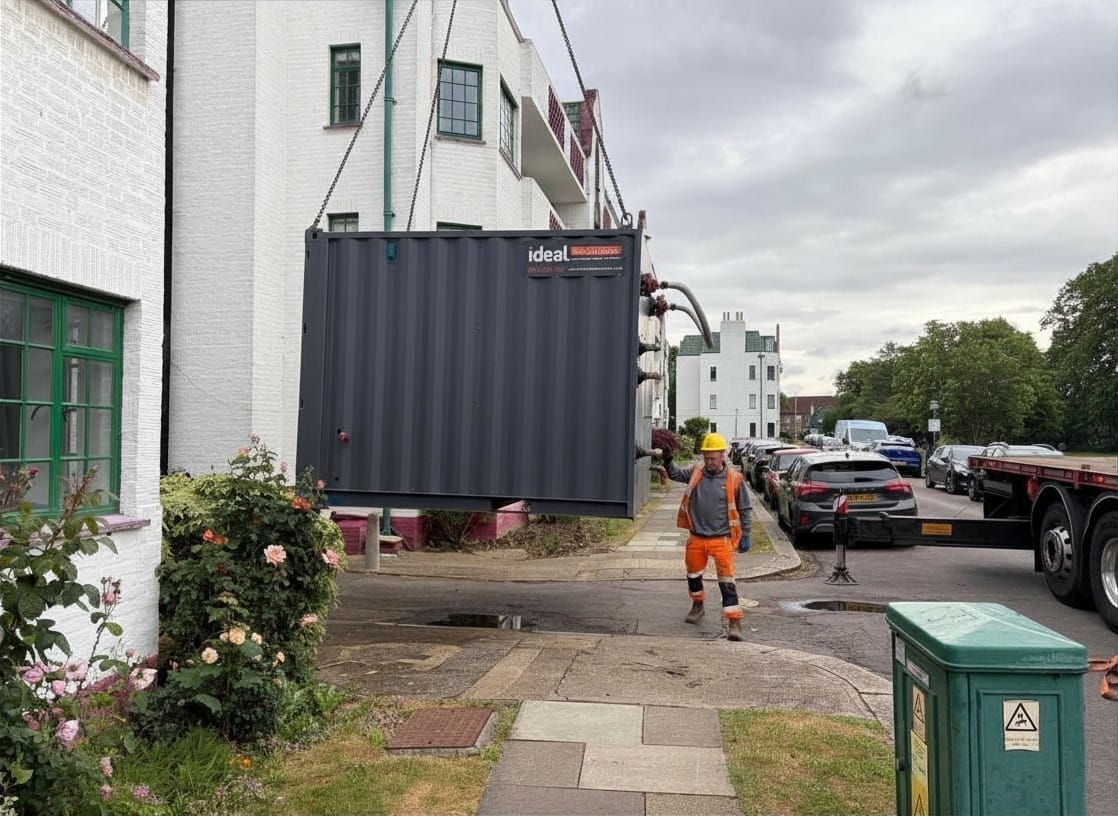

- Lead time for logistics, including parking suspensions or crane operations if required
- A clear connection plan that minimises the duration of any transition from permanent to temporary
- Agreed commissioning and decommissioning dates aligned to the project programme
Ideally, temporary equipment is installed and commissioned while the permanent boiler is still operational. This allows the system to be fully tested before the changeover, eliminating any service gap.
Sizing the Temporary System Correctly
A common mistake in temporary boiler hire for occupied buildings is under-sizing the equipment. The temporary boiler must be capable of meeting the building’s full heating and hot water demand , not just the average load, but the morning hot water peak and the design heating load on the coldest day.
For multi-tenanted commercial buildings with diverse occupancy, we carry out a load assessment that considers:
- Total building heating demand based on floor area and building fabric
- Hot water demand based on the number of occupants and usage patterns
- Any process or specialist loads, such as swimming pools or catering
- Appropriate diversification and margin for peak conditions

Connecting to the Existing Building Infrastructure
In most cases, we connect the temporary boiler to the building’s existing primary heating circuit via the boiler house or plant room. This allows the building’s existing distribution pipework, controls, and heat emitters to function exactly as normal; the only change is that heat is being generated by the temporary unit rather than the permanent boiler.
We use flexible stainless steel hose for all temporary connections, which can be made and broken quickly as the project requires. Our ancillary package includes everything needed to interface correctly with the building’s pressurisation, expansion, and safety systems.
Managing the Transition
The most critical moment in any planned boiler replacement project is the transition, the period when the permanent boiler is taken offline, and the temporary unit takes over. With proper planning, this can be accomplished in a matter of hours, typically outside peak usage times such as overnight or during a weekend.
Our engineers manage this transition, coordinating with the main contractor and the building manager to ensure a seamless changeover. A site engineer remains on hand during and immediately after the transition to verify performance and address any issues.
Ongoing Management During the Project
For projects lasting weeks or months, ongoing management of the temporary system is important. We provide:
- Remote BMS monitoring of all packaged units via Trend
- Regular fuel deliveries with telemetry-based monitoring for oil-fired units
- Routine service visits at agreed intervals
- 24/7 support for any alarms or performance issues
Conclusion
Commercial boiler hire for planned refurbishments is one of the most effective risk management tools available to property managers and landlords. It protects tenant relationships, maintains legal and contractual compliance, and allows boiler replacement projects to proceed at their own pace without pressure from a cold building.
If you are planning a boiler replacement or plant room upgrade in an occupied commercial building, speak to Ideal Heat Solutions early in the project planning process. The earlier we are involved, the smoother the project will be. Call us on 01622 632 918.
